Introduction: Bringing Order to Project Chaos
In today’s fast-paced business environment, effective prioritization isn’t just helpful—it’s essential. Whether you’re managing a complex software development project, planning a marketing campaign, or organizing your personal workload, the ability to distinguish between critical tasks and nice-to-haves can mean the difference between success and failure. This is where the MoSCoW method comes in—a powerful yet straightforward prioritization framework that helps teams clarify what matters most.
The MoSCoW method, pronounced like the Russian capital, isn’t named after the city but is an acronym representing four priority categories: Must-have, Should-have, Could-have, and Won’t-have. Each category helps teams understand the relative importance of requirements and features, creating a shared language for discussing priorities and making tough decisions.
In this comprehensive guide, we’ll explore how the MoSCoW method works, why it’s so effective, and how you can implement it in your projects. Whether you’re new to project management or looking to refine your prioritization approach, you’ll find practical insights to help you deliver more value with less stress.

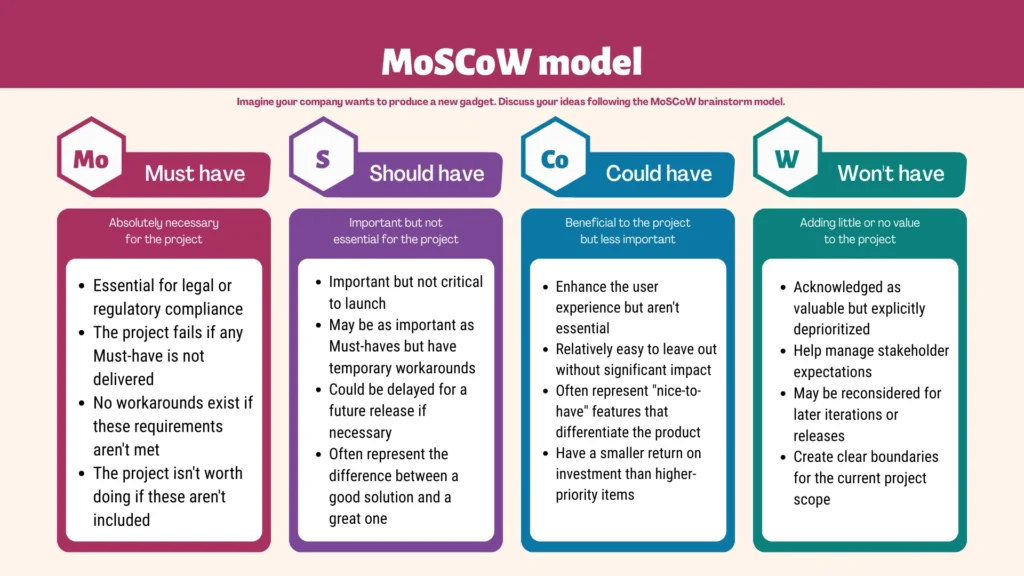

What Is the MoSCoW Method?
The MoSCoW method is a prioritization technique used primarily in project management, business analysis, and software development. It was developed by Dai Clegg in 1994 while working at Oracle and has since become a cornerstone of agile methodologies, particularly Dynamic Systems Development Method (DSDM).
Unlike complex scoring systems or lengthy decision matrices, MoSCoW offers a straightforward way to categorize requirements based on their importance to project success. The simplicity of the framework makes it accessible to team members across all levels of an organization, facilitating clearer communication about priorities.

Breaking Down the MoSCoW Acronym
Let’s examine what each letter in MoSCoW represents:
M – Must-have
Must-have requirements are non-negotiable. These are critical features or tasks without which the project would be considered a failure. Must-haves represent the minimum viable product (MVP) or the bare essentials needed to make the solution work.
Key characteristics of Must-haves:
- Essential for legal or regulatory compliance
- The project fails if any Must-have is not delivered
- No workarounds exist if these requirements aren’t met
- The project isn’t worth doing if these aren’t included
Think of Must-haves as the foundation of your house—without them, everything else falls apart.
S – Should-have
Should-have requirements are important but not vital. These items add significant value and would be painful to leave out, but the project can still function without them in the short term.
Key characteristics of Should-haves:
- Important but not critical to launch
- May be as important as Must-haves but have temporary workarounds
- Could be delayed for a future release if necessary
- Often represent the difference between a good solution and a great one
Should-haves are like the walls and roof of your house—highly desirable and important for comfort, but you could temporarily survive with just the foundation.
C – Could-have
Could-have requirements are desirable but not necessary. These are features that would enhance user satisfaction but are less critical than Should-haves. They’re often the first items to be dropped if resources become constrained.
Key characteristics of Could-haves:
- Enhance the user experience but aren’t essential
- Relatively easy to leave out without significant impact
- Often represent “nice-to-have” features that differentiate the product
- Have a smaller return on investment than higher-priority items
Think of Could-haves as the interior decoration of your house—they make it more pleasant and appealing but aren’t strictly necessary for habitation.
W – Won’t-have (this time)
Won’t-have items are recognized as requirements that won’t be implemented in the current delivery timeframe but may be considered for the future. Explicitly stating what won’t be included is just as important as defining what will be included.
Key characteristics of Won’t-haves:
- Acknowledged as valuable but explicitly deprioritized
- Help manage stakeholder expectations
- May be reconsidered for later iterations or releases
- Create clear boundaries for the current project scope
Won’t-haves are like a wish list for future home improvements—things you’ve decided not to invest in now but might revisit later.
The “o”s in MoSCoW are added to make the acronym pronounceable and memorable, rather than representing specific terms.
Why the MoSCoW Method Works
The MoSCoW method has endured as a popular prioritization tool for several compelling reasons:
1. Simplicity and Clarity
Unlike complex numerical scoring systems, MoSCoW uses plain language that everyone can understand. This clarity helps prevent misinterpretations and ensures all team members and stakeholders share the same understanding of priorities.
2. Stakeholder Alignment
By categorizing requirements into clear priority levels, MoSCoW creates a common language for discussing and negotiating priorities. This facilitates conversations between technical teams, business stakeholders, and end users.
3. Scope Management
The explicit Won’t-have category helps manage scope creep by clearly documenting what’s out of bounds for the current iteration. This reduces the risk of project bloat and helps maintain focus on what matters most.
4. Flexibility
MoSCoW works across various project types and methodologies. Whether you’re using agile, waterfall, or a hybrid approach, the framework adapts to your needs.
5. Resource Optimization
By distinguishing between absolute necessities and nice-to-haves, MoSCoW helps teams allocate limited resources more effectively, ensuring critical needs are met before less important features consume time and budget.
Implementing the MoSCoW Method: A Step-by-Step Guide
Applying the MoSCoW method effectively requires more than just assigning categories to requirements. Here’s a step-by-step process to implement MoSCoW in your projects:
Step 1: Gather All Requirements
Begin by collecting all potential requirements, features, or tasks for your project. Involve all stakeholders in this process to ensure nothing is overlooked. Use techniques like workshops, interviews, surveys, and brainstorming sessions to create a comprehensive list.
Step 2: Educate Participants on MoSCoW Categories
Before categorization begins, ensure everyone understands what each MoSCoW category means. Provide clear definitions and examples relevant to your project context. This creates a shared understanding and vocabulary for the prioritization discussions.
Step 3: Set Boundaries and Constraints
Clearly define the project constraints, such as:
- Budget limitations
- Timeline requirements
- Resource availability
- Technical limitations
- Regulatory requirements
These constraints provide context for making realistic prioritization decisions.
Step 4: Collaborative Categorization
Bring stakeholders together to categorize each requirement according to the MoSCoW framework. This should be a collaborative process where different perspectives are considered. Encourage open discussion and healthy debate about the relative importance of each item.
During this process:
- Challenge “must-have” designations rigorously—many items that initially feel essential may actually be should-haves
- Use dot voting or similar techniques to help reach consensus
- Document the reasoning behind categorizations for future reference
Step 5: Balance the Distribution
Aim for a balanced distribution of requirements across categories. As a general guideline:
- Must-haves: 60% of total effort
- Should-haves: 20% of total effort
- Could-haves: 20% of total effort
- Won’t-haves: Outside current scope
If your Must-haves exceed 60%, you may need to reconsider your priorities or adjust the project scope.
Step 6: Review and Refine
Once you’ve completed the initial categorization, review the results as a whole:
- Do the Must-haves truly represent the minimum viable product?
- Are there any inconsistencies in how similar items were categorized?
- Is the overall balance realistic given your constraints?
Make adjustments as needed to ensure the categorization is both consistent and achievable.
Step 7: Document and Communicate
Create clear documentation of the prioritized requirements, including:
- The MoSCoW category for each item
- A brief rationale for each categorization
- Any dependencies between requirements
- Potential impact if lower-priority items aren’t delivered
Share this information with all stakeholders to ensure everyone understands and agrees with the priorities.
Step 8: Monitor and Adapt
As the project progresses, regularly review and update your MoSCoW categorizations:
- Could new information change previous priorities?
- Are we on track to deliver all Must-haves?
- Should some Should-haves be upgraded to Must-haves (or vice versa)?
Prioritization is not a one-time activity but an ongoing process that evolves with the project.
MoSCoW Method in Action: Real-World Examples
To better understand how MoSCoW works in practice, let’s look at some examples across different contexts:
Example 1: E-commerce Website Redesign
A retail company is redesigning their e-commerce website with a tight three-month deadline. Here’s how they might apply MoSCoW:
Must-have:
- Mobile-responsive design (the majority of customers shop on mobile)
- Secure payment processing integration
- Product catalog with search functionality
- Customer account management
- Shopping cart and checkout process
Should-have:
- Product recommendation engine
- Customer reviews and ratings
- Saved payment methods
- Order tracking system
- Wishlist functionality
Could-have:
- Social media integration
- Live chat customer support
- Virtual try-on features
- Loyalty program integration
- Advanced filtering options
Won’t-have (this time):
- Augmented reality product visualization
- Voice search capability
- International shipping calculator
- Subscription service model
- Custom product builder
By categorizing features this way, the team can focus first on building a functional e-commerce site that meets core user needs, while planning to add enhancements in later phases.
Example 2: Personal Finance App Development
A fintech startup is developing a new personal finance management app:
Must-have:
- Bank account connection and transaction importation
- Basic expense categorization
- Monthly budget setting
- Secure data storage and encryption
- User authentication
Should-have:
- Spending analytics and reports
- Bill payment reminders
- Savings goals tracking
- Custom category creation
- Recurring transaction detection
Could-have:
- Investment portfolio tracking
- Tax preparation features
- Financial advice engine
- Split transaction capability
- Receipt scanning and storage
Won’t-have (this time):
- Cryptocurrency trading
- Peer-to-peer payments
- Loan application process
- Credit score monitoring
- Insurance comparison tools
This prioritization helps the startup launch with core financial management features while planning future enhancements based on user feedback and business growth.
Example 3: Corporate Training Program
A human resources department is developing a leadership training program for middle managers:
Must-have:
- Communication skills workshop
- Performance management training
- Company policy and compliance education
- Basic conflict resolution techniques
- Goal setting and accountability modules
Should-have:
- Team building activities
- Emotional intelligence assessment
- Mentorship program guidelines
- Feedback delivery practice sessions
- Change management strategies
Could-have:
- Advanced negotiation techniques
- Industry-specific leadership scenarios
- Guest speaker sessions
- Personal leadership style assessment
- Cross-departmental collaboration exercises
Won’t-have (this time):
- Executive shadowing program
- International business etiquette
- Public speaking intensive
- Crisis management simulation
- Strategic planning certification
This prioritization ensures the program delivers essential leadership skills while keeping the training program within budget and time constraints.
Adapting MoSCoW for Different Project Methodologies
The MoSCoW method is versatile and can be adapted to various project management approaches:
MoSCoW in Agile Environments
In agile frameworks like Scrum or Kanban, MoSCoW helps teams make decisions about which user stories or features to include in each sprint or iteration:
- Must-haves typically go into early sprints
- Should-haves get scheduled after Must-haves are completed
- Could-haves are implemented if sprint capacity allows
- Won’t-haves remain in the product backlog for future consideration
MoSCoW works particularly well with the incremental delivery approach of agile, allowing teams to deliver the most valuable features first while maintaining flexibility to adapt priorities based on feedback.
MoSCoW in Traditional Waterfall Projects
In waterfall projects, MoSCoW can help with:
- Defining clear acceptance criteria for project phases
- Managing stakeholder expectations about what will be delivered
- Making trade-off decisions when time or budget constraints arise
- Providing clarity on what constitutes project completion
While waterfall projects have less flexibility to adjust scope mid-project, MoSCoW still provides a valuable framework for initial requirement prioritization and scope definition.
MoSCoW for Personal Task Management
Beyond formal project management, individuals can use MoSCoW for personal productivity:
- Must-do: Tasks that have serious consequences if not completed today
- Should-do: Important tasks that have less immediate consequences
- Could-do: Nice-to-accomplish tasks that won’t impact key outcomes
- Won’t-do: Tasks explicitly deprioritized for today
This application of MoSCoW helps individuals focus on their most important tasks while consciously deprioritizing less critical activities.
Common Pitfalls and How to Avoid Them
Despite its simplicity, teams can encounter challenges when implementing MoSCoW. Here are common pitfalls and strategies to overcome them:
Pitfall 1: Too Many Must-haves
The Problem: When everything is labeled as “Must-have,” nothing is truly prioritized, defeating the purpose of the method.
Solution:
- Challenge each Must-have with “What happens if we don’t do this?”
- Set a hard limit (like 60% of capacity) for Must-have items
- Ask “Could we launch without this?” for each requirement
- Identify true dependencies to distinguish genuine Must-haves
Pitfall 2: Neglecting Won’t-haves
The Problem: Teams often focus on what they will do and forget to explicitly document what they won’t do.
Solution:
- Always include the Won’t-have category in your prioritization discussions
- Document Won’t-haves as thoroughly as other categories
- Review the Won’t-have list with stakeholders to ensure alignment
- Use Won’t-haves to manage expectations and prevent scope creep
Pitfall 3: Stakeholder Disagreement
The Problem: Different stakeholders often have conflicting priorities and may disagree on categorizations.
Solution:
- Focus discussions on business value and user needs rather than personal preferences
- Use objective criteria for prioritization (e.g., customer impact, revenue potential, cost, risk)
- Employ techniques like weighted voting to resolve disagreements
- Engage a neutral facilitator for prioritization sessions
Pitfall 4: Static Prioritization
The Problem: Treating MoSCoW categorization as a one-time event rather than an evolving process.
Solution:
- Schedule regular priority reviews throughout the project
- Create a simple process for proposing and approving priority changes
- Document the reasoning behind priority shifts
- Communicate changes proactively to all stakeholders
Pitfall 5: Forgetting the Context
The Problem: Applying MoSCoW without considering the specific constraints and goals of the project.
Solution:
- Always start prioritization by clarifying the project vision and constraints
- Document these constraints as reference points for prioritization decisions
- Revisit the constraints when there’s pressure to upgrade lower-priority items
- Consider creating custom subcategories within MoSCoW that reflect your specific context
Beyond Basic MoSCoW: Advanced Techniques
Once you’re comfortable with the standard MoSCoW approach, consider these advanced techniques to enhance your prioritization process:
Time-based MoSCoW
Add a time dimension to your MoSCoW categories by considering when requirements need to be implemented:
- Must-have now
- Must-have by [specific milestone]
- Should-have by [specific milestone]
- Could-have if time permits before [specific milestone]
- Won’t-have before [specific milestone]
This approach helps with release planning and resource allocation across longer projects with multiple delivery phases.
Value-Effort MoSCoW
Combine MoSCoW with a simple value-effort assessment:
- Categorize requirements using standard MoSCoW
- Within each category, assess items based on:
- Value (high/medium/low)
- Effort required (high/medium/low)
- Prioritize higher-value, lower-effort items within each MoSCoW category
This creates a more granular prioritization within categories, helping teams choose between items of similar importance.
MoSCoW with Numerical Weighting
For more complex projects, you might combine MoSCoW with numerical weighting:
- Must-have: 8-10 points
- Should-have: 5-7 points
- Could-have: 2-4 points
- Won’t-have: 0-1 points
Team members individually score each requirement, and the average scores determine the final MoSCoW category. This approach brings more objectivity to the process while maintaining the clarity of the MoSCoW framework.
MoSCoW with Risk Assessment
Add risk evaluation to your MoSCoW prioritization:
- Categorize requirements using standard MoSCoW
- Assess the risk associated with each requirement (likelihood and impact)
- Flag high-risk items for special attention, regardless of their MoSCoW category
- Develop mitigation strategies for high-risk Must-haves
This ensures that risk is explicitly considered alongside priority in your planning.
MoSCoW vs. Other Prioritization Methods
To understand when MoSCoW is most appropriate, it’s helpful to compare it with other popular prioritization frameworks:
MoSCoW vs. Kano Model
Kano Model: Categorizes features based on customer satisfaction into Basic, Performance, Excitement, Indifferent, and Reverse features.
Key Differences:
- Kano focuses specifically on customer delight, while MoSCoW is more broadly applicable
- Kano requires customer research, whereas MoSCoW can be applied with internal expertise
- Kano is best for product development, while MoSCoW works across many project types
When to Choose:
- Use Kano when deep customer insight is available and user delight is the primary goal
- Use MoSCoW for general project prioritization, especially with time or resource constraints
MoSCoW vs. Value vs. Effort Matrix
Value vs. Effort: Plots items on a 2×2 matrix based on business value and implementation effort.
Key Differences:
- Value vs. Effort is highly visual, while MoSCoW is more categorical
- Value vs. Effort explicitly considers resource requirements, whereas MoSCoW focuses on necessity
- Value vs. Effort can be more subjective without clear definitions
When to Choose:
- Use Value vs. Effort for quick prioritization with limited stakeholders
- Use MoSCoW when you need clear categories and broader stakeholder alignment
MoSCoW vs. Weighted Scoring
Weighted Scoring: Evaluates options against multiple weighted criteria, producing a numerical score for each item.
Key Differences:
- Weighted scoring provides more granular differentiation between items
- MoSCoW is simpler to implement and communicate
- Weighted scoring can appear more objective but often hides subjective judgments in complex formulas
When to Choose:
- Use weighted scoring for highly complex decisions with many factors
- Use MoSCoW when communication and stakeholder alignment are crucial
Tools and Technologies for MoSCoW Implementation
While MoSCoW can be implemented with basic tools like spreadsheets or whiteboards, various digital tools can enhance the process:
Project Management Software
Many project management platforms support MoSCoW implementation:
- Jira: Create custom fields for MoSCoW categories and use them to filter and prioritize issues
- Trello: Use labels or lists to represent MoSCoW categories
- Asana: Create custom fields or use tags to implement MoSCoW
- Microsoft Project: Create custom fields and filters based on MoSCoW categories
Dedicated Prioritization Tools
Some specialized tools include built-in support for MoSCoW:
- ProductPlan: Includes MoSCoW categorization in its roadmapping features
- ProdPad: Offers MoSCoW as a prioritization method for product features
- Airfocus: Provides MoSCoW frameworks in its prioritization templates
Collaborative Workshops
For interactive prioritization sessions:
- Miro: Create MoSCoW boards where teams can collaboratively drag and drop requirements
- Mural: Use templates for MoSCoW prioritization exercises
- Lucidspark: Create interactive MoSCoW quadrants for team prioritization
Simple Solutions
Don’t overlook simple, accessible tools:
- Google Sheets or Excel: Create columns for each MoSCoW category
- Color-coded sticky notes: Physical or digital, using different colors for each category
- Kanban boards: Use columns to represent MoSCoW categories
Conclusion: Making MoSCoW Work for You
The MoSCoW method offers a powerful yet accessible framework for making tough prioritization decisions. Its strength lies in creating clarity, facilitating communication, and establishing shared understanding about what matters most to project success. By distinguishing between must-haves, should-haves, could-haves, and won’t-haves, teams can focus their limited resources on delivering maximum value.
While no prioritization framework is perfect for every situation, MoSCoW’s flexibility allows it to be adapted to various contexts—from software development to marketing campaigns, personal productivity to corporate strategic planning. By understanding both the core principles and potential pitfalls of MoSCoW, you can tailor the approach to your specific needs.
Remember that effective prioritization is not a mechanical process but a balance of analytical thinking and stakeholder alignment. The real power of MoSCoW comes not just from the categorization itself but from the conversations it facilitates about what truly matters to project success.
As you implement MoSCoW in your projects, focus not just on assigning categories but on building shared understanding. With practice, MoSCoW can become more than just a prioritization tool—it can transform how your team thinks about value, importance, and successful delivery.
Frequently Asked Questions
What does MoSCoW stand for?
Answer: MoSCoW stands for Must-have, Should-have, Could-have, and Won’t-have. These categories represent different priority levels for requirements or features within a project. Must-haves are non-negotiable essentials without which the project would fail. Should-haves are important but not critical for initial launch. Could-haves are desirable enhancements that could be delivered if resources allow. Won’t-haves are items explicitly excluded from the current scope but may be considered for future iterations. The “o”s in the acronym are added to make it pronounceable and memorable, rather than representing specific terms.
When is MoSCoW most effective as a prioritization tool?
Answer: MoSCoW is most effective in situations where clear communication about priorities is essential, especially among diverse stakeholders with different perspectives. It works particularly well for time-boxed projects with fixed deadlines and limited resources, where tough decisions about scope are necessary. MoSCoW excels in agile environments with iterative delivery, as it helps teams decide what to include in each increment. It’s also valuable when stakeholders have competing priorities that need reconciliation. The method is especially powerful when the consequences of not delivering certain features are significant but not always obvious to all parties involved. MoSCoW creates a shared language for these crucial prioritization discussions, making it ideal for complex projects with multiple stakeholders.
How is MoSCoW different from other prioritization methods?
Answer: MoSCoW differs from other prioritization methods in several key ways. Unlike numerical scoring systems (like weighted scoring), MoSCoW uses plain language categories that are intuitive and accessible to non-technical stakeholders. While methods like Cost of Delay focus primarily on economic impact, MoSCoW takes a more holistic view that can incorporate various factors including risk, strategic alignment, and operational necessity. Compared to the Kano Model, which categorizes features based on customer satisfaction, MoSCoW is more project-focused and considers internal constraints. The Value vs. Effort matrix plots items on two dimensions, whereas MoSCoW creates distinct categorical groups. What truly distinguishes MoSCoW is its explicit inclusion of the “Won’t-have” category, which helps manage scope creep by clearly documenting what’s excluded. This combination of simplicity, clarity, and comprehensive categorization makes MoSCoW uniquely effective for aligning diverse stakeholders around project priorities.
What percentage of requirements should fall into each MoSCoW category?
Answer: While there’s no one-size-fits-all distribution for MoSCoW categories, many practitioners recommend a guideline of 60% Must-haves, 20% Should-haves, and 20% Could-haves (with Won’t-haves being uncounted since they’re out of scope). This “60-20-20 rule” helps ensure that the project remains focused on essentials while still allowing some flexibility. However, these percentages should be adapted based on project context. For highly constrained projects, Must-haves might need to be limited to 50% or less of total capacity to ensure deliverability. For exploratory or innovation projects, the Could-have category might be intentionally larger to encourage experimentation. The key principle is that Must-haves should never consume 100% of available resources—this defeats the purpose of prioritization and leaves no buffer for uncertainties. Ultimately, the right distribution depends on your project’s specific constraints, objectives, and risk tolerance, but should always lead to a realistic and achievable set of Must-haves.
How often should MoSCoW priorities be revisited during a project?
Answer: MoSCoW priorities should be revisited regularly throughout the project lifecycle, not just set once at the beginning. For agile projects, review priorities at least at the start of each iteration or sprint (typically every 1-4 weeks) to ensure they still align with current understanding and business needs. For longer waterfall-style projects, schedule formal priority reviews at key milestones or phase transitions, typically every 4-6 weeks. Additionally, significant events should trigger immediate priority reassessment, including major changes in business direction, unexpected technical challenges, resource changes, or important new customer insights. The frequency of reviews should increase as you approach critical deadlines, when trade-off decisions become more pressing. Remember that changing priorities isn’t a sign of poor planning but rather an appropriate response to new information and evolving project realities. The goal is to maintain a dynamic, relevant prioritization that reflects current project understanding rather than adhering rigidly to initial assumptions.
Can a requirement change its MoSCoW category during the project?
Answer: Yes, requirements can and often should change MoSCoW categories during a project as new information emerges. A Should-have might be upgraded to a Must-have if its importance becomes clearer or if it’s discovered to be a dependency for other critical features. Conversely, a Must-have might be downgraded to a Should-have if an acceptable workaround is identified or if business priorities shift. Requirements might move between Could-have and Won’t-have categories as resource availability changes or as customer feedback clarifies their relative value. These changes should be managed through a defined process that includes documenting the rationale for the change, assessing the impact on the project plan, and communicating the change to all stakeholders. While allowing this flexibility, teams should be cautious about frequent recategorization of Must-haves, as this can undermine confidence in the prioritization process. The key is striking a balance between maintaining stable priorities and responding appropriately to new information that genuinely warrants reconsideration.
How can I handle stakeholders who insist everything is a “Must-have”?
Answer: Handling stakeholders who classify everything as “Must-have” requires a combination of education, facilitation techniques, and objective criteria. Start by ensuring everyone understands the strict definition of Must-have—not “important” or “valuable,” but truly essential for the solution to work at all. Use the “business failure” test: ask, “Would the business literally fail if this requirement isn’t met in this timeframe?” to challenge inflated Must-haves. Introduce resource constraints explicitly by showing the capacity available and demonstrating that not everything can fit. Facilitate prioritization exercises where stakeholders must trade off requirements against each other, such as forced ranking or budget allocation simulations. Implement a “Must-have budget” where each stakeholder gets a limited number of “Must-have votes” to allocate. Bring objective criteria into discussions, such as quantitative measures of customer impact, revenue potential, or risk mitigation. Finally, demonstrate the consequences of over-classification by showing how previous projects with too many Must-haves either failed to deliver on time or required painful late-stage scope cuts. The goal is to shift from emotional attachment to rational assessment of true necessity.
Does MoSCoW work for non-software projects?
Answer: Absolutely! While MoSCoW originated in software development, it’s highly effective for prioritizing requirements in virtually any project type. In construction projects, MoSCoW can distinguish between structural necessities (Must-haves) and aesthetic enhancements (Could-haves). Event planners use it to separate mission-critical elements like venue and catering (Must-haves) from nice-to-have touches like specialty lighting (Could-haves). Marketing teams apply MoSCoW to campaign elements, distinguishing between core messaging (Must-haves) and additional channels (Should/Could-haves). Educational curriculum developers use it to prioritize learning objectives, ensuring essential concepts receive appropriate focus. Even personal projects benefit from MoSCoW—whether planning a wedding, home renovation, or career transition. The method’s strength lies in its simplicity and focus on relative importance rather than domain-specific criteria. This makes it adaptable to virtually any context where limited resources require prioritization decisions. The key to applying MoSCoW outside software is adapting the definitions of the categories to fit your specific context while maintaining the core principle of distinguishing between absolute necessities and desirable enhancements.
How detailed should requirements be before applying MoSCoW?
Answer: Requirements should be defined with enough detail to make informed prioritization decisions, but don’t need to be fully specified before applying MoSCoW. At minimum, each requirement should have a clear, concise description that all stakeholders can understand; identified business value or purpose; and rough size/complexity estimation. Without these elements, prioritization decisions risk being based on misunderstandings or incomplete information. That said, different MoSCoW categories often warrant different levels of detail: Must-haves generally need more thorough definition earlier because they’re critical to delivery, while Could-haves can often start with higher-level descriptions that are elaborated only if they make it into the delivery scope. The most effective approach is usually progressive elaboration—start with enough detail to make initial MoSCoW categorizations, then further develop the requirements as they move closer to implementation, beginning with Must-haves. This prevents wasting effort on detailed specifications for lower-priority items that might not be implemented, while ensuring critical requirements receive appropriate attention.
How can I use MoSCoW for personal productivity and task management?
Answer: Adapting MoSCoW for personal productivity creates a powerful framework for daily task management. Start each day or week by listing all your tasks, then categorize them: Must-do tasks have serious consequences if not completed by their deadline—think tax filings, critical work deliverables, or time-sensitive health appointments. Should-do tasks are important but have some flexibility—regular exercise, progress on medium-priority projects, or routine household maintenance. Could-do tasks would be beneficial but can be postponed—organizing digital files, non-urgent home improvements, or optional social engagements. Won’t-do tasks are explicitly deprioritized for now—interesting but non-essential reading, hobby projects, or tasks you’re consciously deferring until a specific future time. For daily planning, aim to complete all Must-dos, most Should-dos, and any Could-dos only if time permits. The power of personal MoSCoW lies in making conscious decisions about what not to do today, reducing the guilt and mental load of an ever-growing task list. Review and update your categories regularly as priorities shift. This approach brings clarity to personal time management while maintaining flexibility for life’s inevitable surprises.
Can MoSCoW work in environments with changing requirements?
Answer: MoSCoW is particularly well-suited for environments with changing requirements, as it provides structure while maintaining flexibility. The key is implementing MoSCoW as a dynamic process rather than a one-time classification. Establish regular priority review sessions that coincide with your project’s natural rhythm—sprint planning in agile environments or phase transitions in more traditional projects. Create a simple, documented process for proposing and approving priority changes that includes justification requirements and stakeholder notification. Use the Won’t-have category actively as a “parking lot” for requirements that might return later, rather than simply rejecting them. Consider implementing time-based MoSCoW, where requirements can move between categories at different project phases. Maintain a clear connection between MoSCoW categories and your risk management process—when risks materialize, priorities often need adjustment. Document not just the current MoSCoW categorization but also the underlying reasoning, so when circumstances change, you can quickly identify which priorities might be affected. With these adaptations, MoSCoW becomes not just compatible with changing requirements but a valuable tool for managing them effectively, providing both structure and adaptability to evolving project needs.
